KYTC Richmond Road Improvements

Project Overview

This $13 million KYTC project will build new RCUTs (Reduced Conflict U-Turn) along Richmond Road (U.S. 25) and Athens-Boonesboro Road (KY 418) south of Man O’ War Boulevard in Lexington – a proven design that reduces crashes and enhances traffic flow. Improvements over the next year will include:

  • Safer intersections at Yorkshire and Squires, Ellerslie Park Boulevard and Jacobson Park, Hays Boulevard, Brenda Cowan Elementary, and more
  • Reduced conflict points, and less traffic delay on Richmond Road, Athens-Boonesboro and side roads
  • A new shared use path, new and improved Jacobson Park entrance, and a better U.S. 25 (Old Richmond Road) intersection

Project Updates

All District 7 press releases can be viewed here: News Archive | KYTC

Construction Phase Information

Construct the outside full depth lanes and shoulders of Richmond Road and Athens-Boonesboro Road (US 25 / KY 418).

  • Short term lane closures may occur as needed for the outside lane from 9 AM to 4 PM.
  • Construction of a new section of US 25 along Aphids Way will be completed in Phases 1 & 2. Aphids Way will be closed to traffic during construction and traffic should use Old Richmond Road.
Construction Map

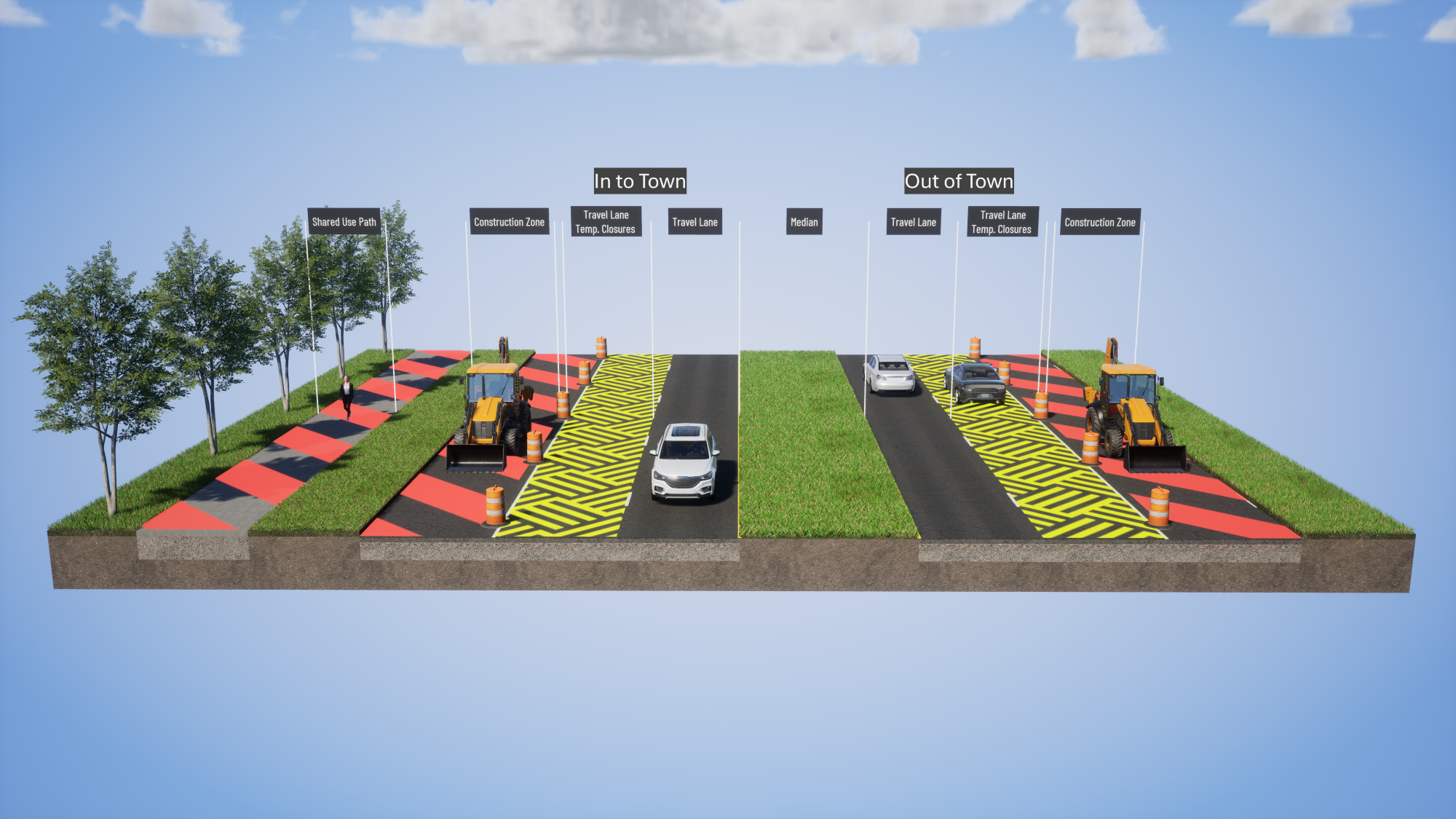

Phase One graphic
Click to enlarge

Construction in the median of Richmond Road and Athens-Boonesboro Road (US 25 / KY 418).

  • Construct the median islands for the U-turn crossovers and left turn lanes to provide U-turn access to side roads.
  • Short term lane closures may occur as needed for the outside lane from 9 AM to 4 PM.
  • Construction of a new section of US 25 along Aphids Way will be completed in Phases 1 & 2. Aphids Way will be closed to traffic during construction and traffic should use Old Richmond Road.
Construction Map

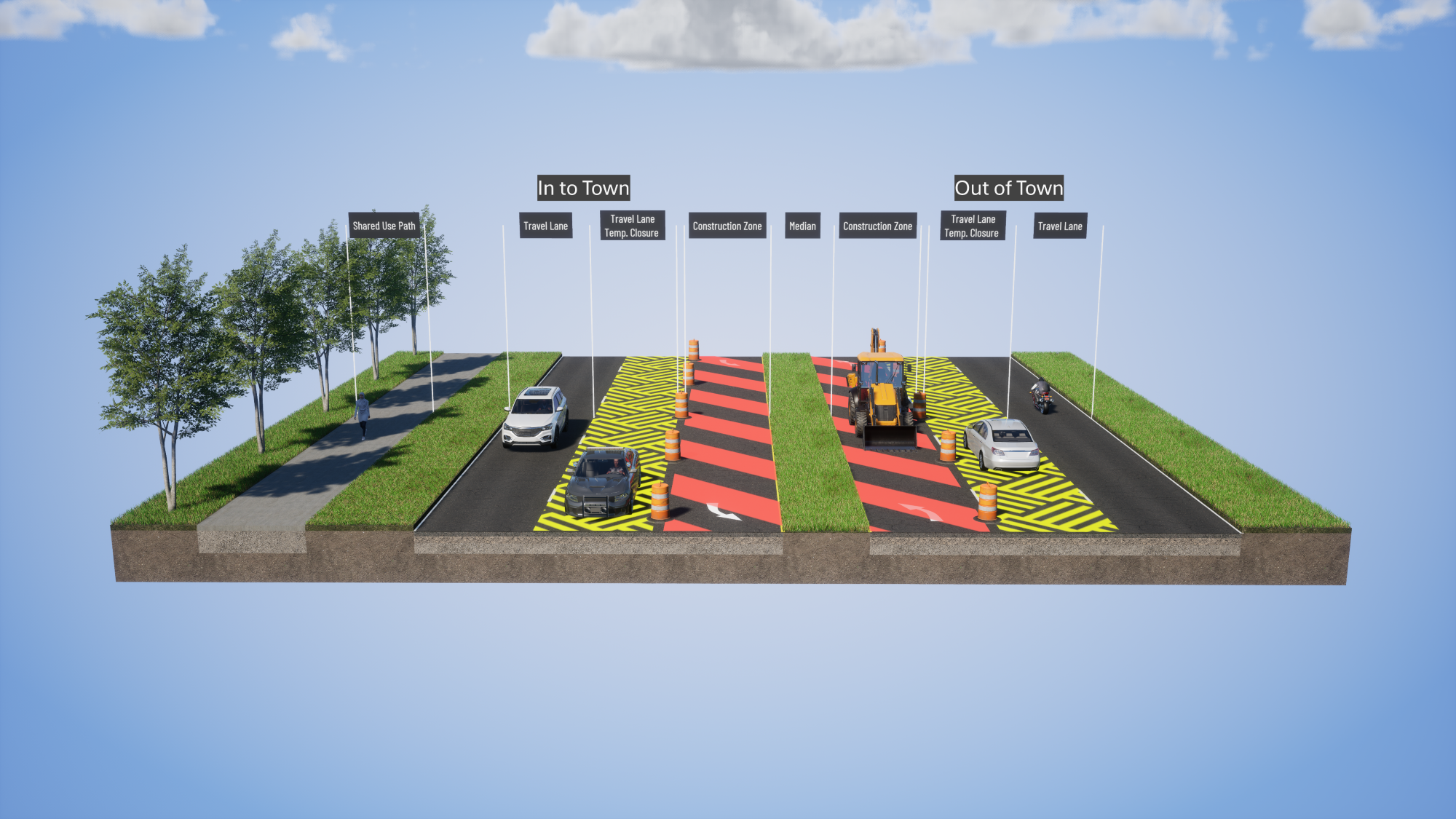

Phase two graphic
Click to enlarge

Construction in the median of Richmond Road and Athens-Boonesboro Road (US 25 / KY 418).

  • Construct the median islands in the intersection to provide RCUT access to the side roads. Left turns at the intersection shall be restricted and drivers may make U-turns at the crossovers.
  • Traffic from the side streets turning left or going through may turn right and use the newly constructed U-turns.
  • Signals at Ellerslie Park Blvd/ Jacobson Park Entrance will become operational after the medians have been constructed and the RCUT is nearing completion.
Construction Map

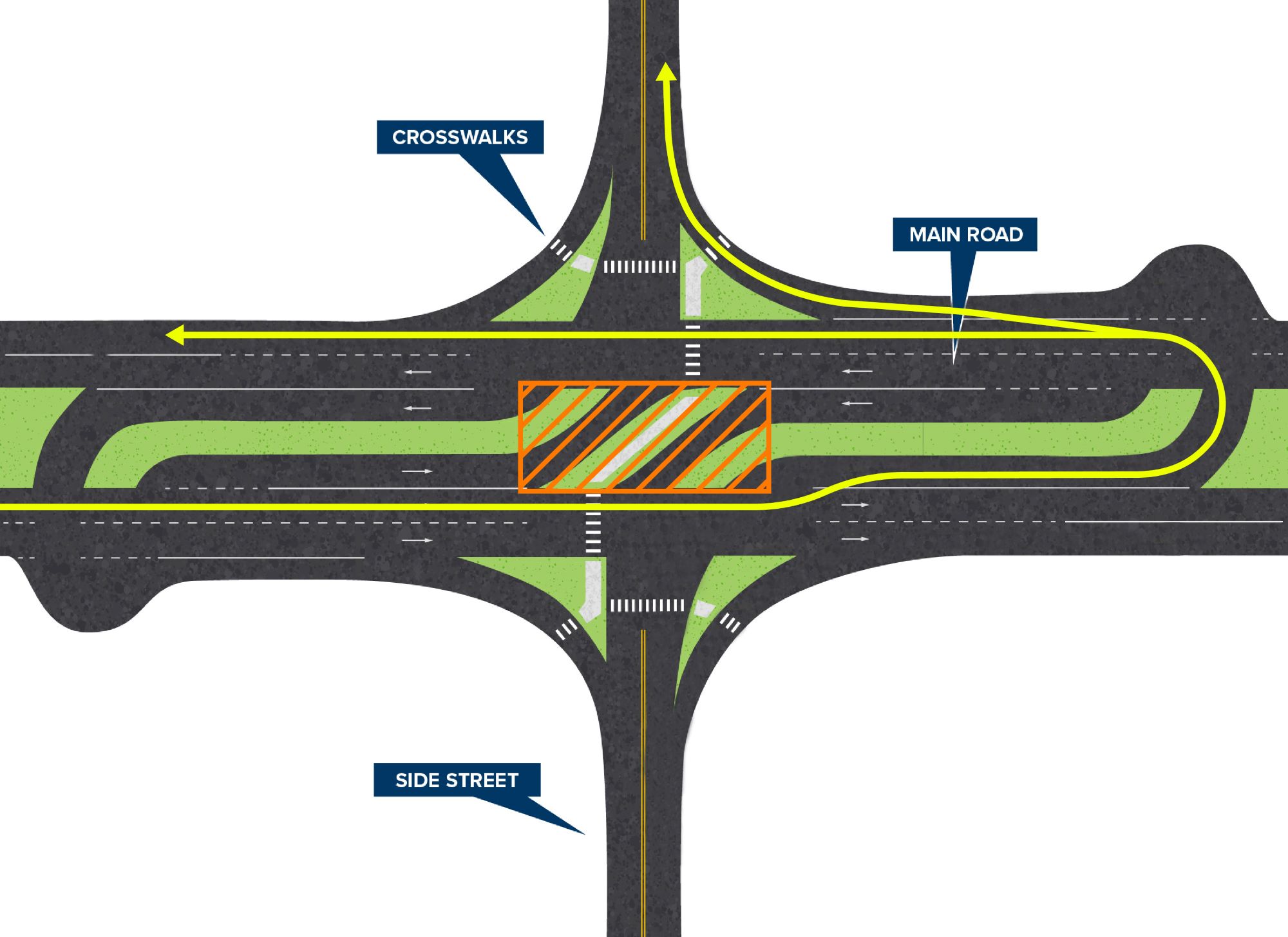

Phase three graphic

Click to enlarge
Phase three top-down graphic
Click to enlarge

Once left turn and through movements from the side roads are restricted (starting in Phase 3), traffic should follow the RCUT flow of traffic shown on the right. See KYTC’s SAFERoad Solutions page for more information about RCUTs.

Perform final blacktop surfacing for the entire project after widening has been completed.

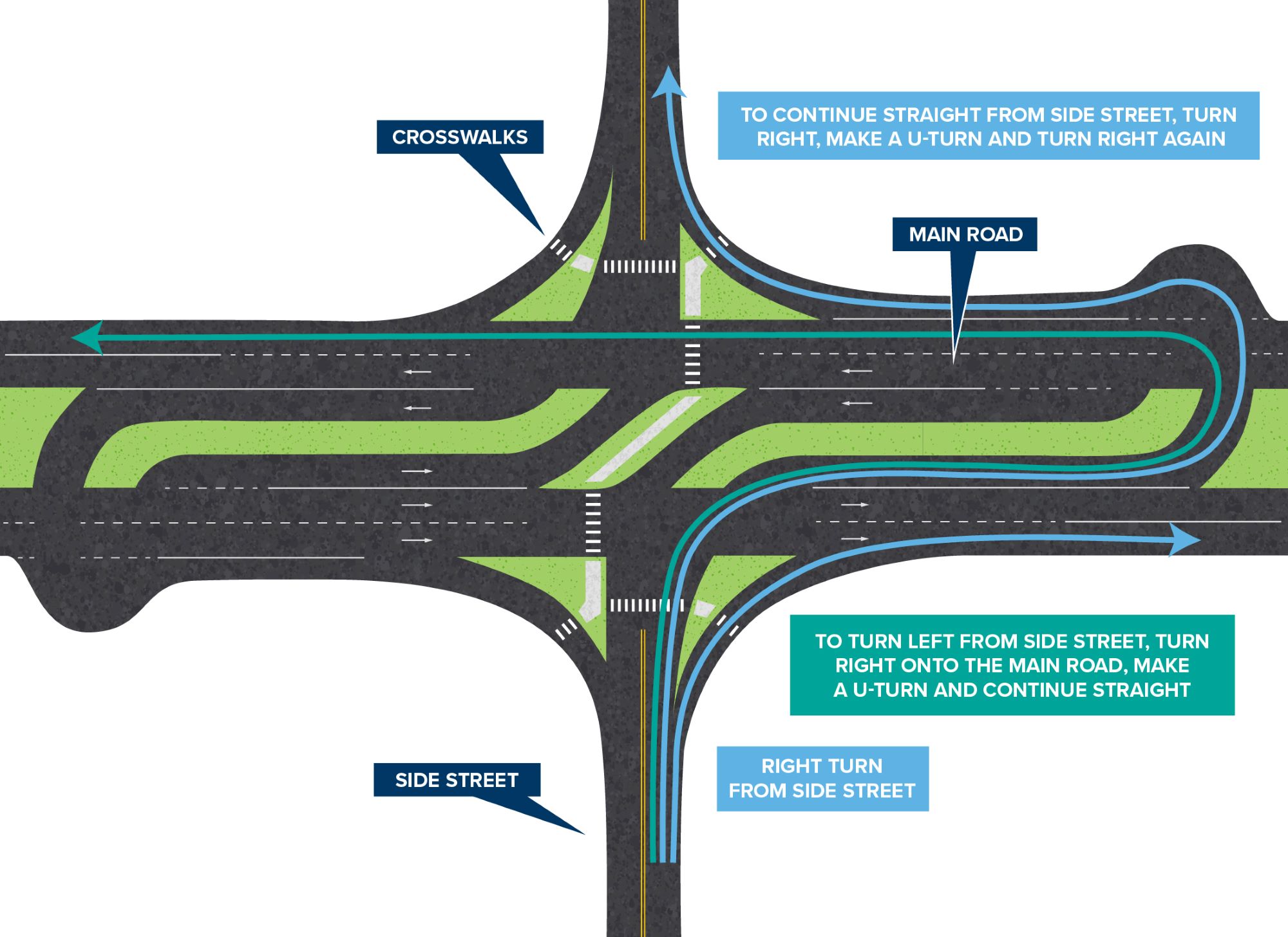

Final phase top-down graphic
Click to enlarge

Interactive Map

Proposed roadway improvements shown, as well as previously constructed RCUT at Competition Drive near I-75.

Legend

Raised Island
New Shared Use Path
Grass Median
Pavement Removal

Our Guide to RCUTS

Project Timeline

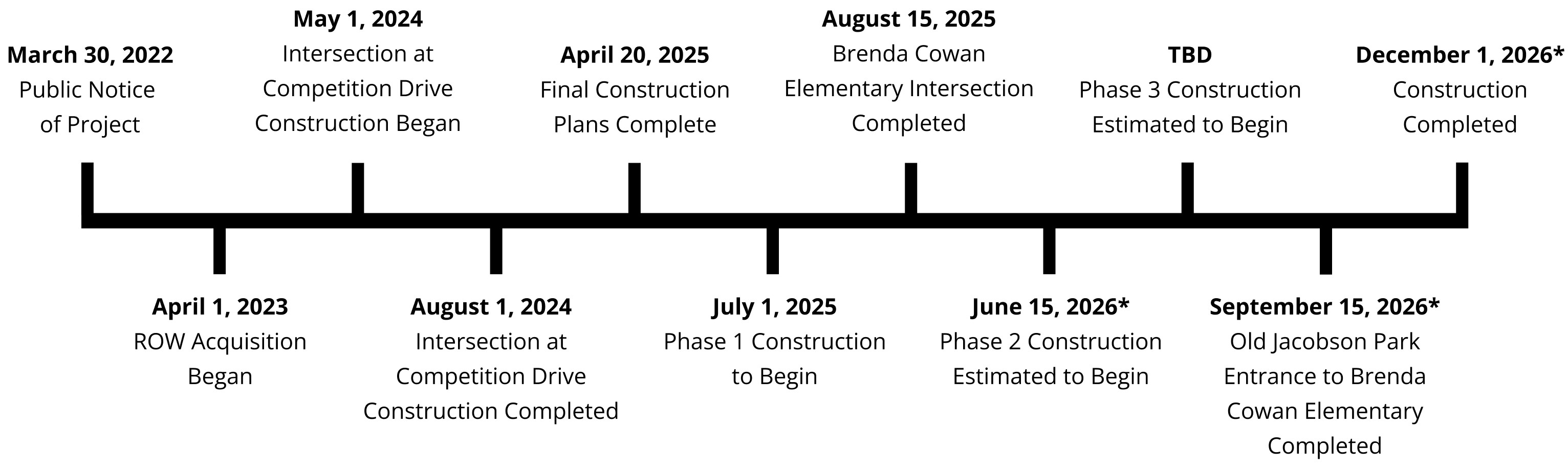

Project timeline showing major milestones from March 30, 2022, through May 15, 2026. Milestones include public notice of project (March 30, 2022), ROW acquisition began (April 1, 2023), Competition Drive intersection construction began (May 1, 2024) and completed (August 1, 2024), final construction plans complete (April 20, 2025), Phase 1 construction begins (July 1, 2025), Brenda Cowan Elementary intersection completed (August 15, 2025), Phase 2 construction begins (June 17, 2026), Eagle Creek to Coys Lane completed (May 15, 2026*), Phase 3 construction begins (September 18, 2026), and Coys Lane to Brenda Cowan Elementary completed (October 23, 2026*). Asterisks indicate projected dates.
Click to enlarge
